Metal deck bearing on steel beams requires specific shear stud placement and puddle weld spacing relative to the deck orientation. Studs are positioned on the side of the flute toward the nearest end of the beam with a minimum one-half inch clearance. Additional studs are provided at the beam ends to meet the count required on the structural plan. Puddle welds secure the deck where no stud is provided, maintaining specified maximum and minimum spacings.

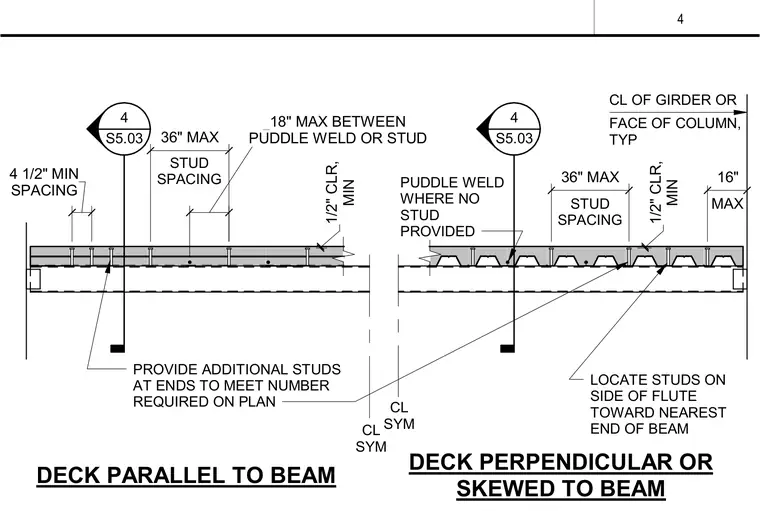

STUD SPACING STUD SPACING CL OF GIRDER OR FACE OF COLUMN, TYP PUDDLE WELD WHERE NO STUD PROVIDED CL SYM CL SYM PROVIDE ADDITIONAL STUDS AT ENDS TO MEET NUMBER REQUIRED ON PLAN LOCATE STUDS ON SIDE OF FLUTE TOWARD NEAREST END OF BEAM DECK PARALLEL TO BEAM DECK PERPENDICULAR OR SKEWED TO BEAM 4 S5.03 ____ 4 S5.03 ____ SPACING 4 1/2" MIN 36" MAX PUDDLE WELD OR STUD 18" MAX BETWEEN MIN 1/2" CLR, 36" MAX MAX 16" MIN 1/2" CLR, 4
